Set Up Award with Two Projects

Purpose

The following guide is intended for Clinical Research Finance Managers who are looking to view or complete any of the following actions:

Action

· Setup Award with an additional project:

· One project with a burden rate and one without burden rate

· Add transactions to each project and run burden process (hyperlinked process within this guide

· Re-budget projects with sub-awards (hyperlinked process within this guide)

Terminology

· Award: Clinical Research Studies Trial (CRS) Awards are grants, funding, or financial support provided to researchers or medical institutions to conduct clinical trials and studies. All clinical study projects managed by OCR/CTFG will start with "CRS".

· Project: Contains financial and demographic information at a more granular level of detail than the award.

· Contract: Vehicle for processing revenue and invoices according to configured methods and controls.

· Burden Schedule: Tool for calculating and applying F&A or any other rate-based add-on cost.

· Project Status: The project status can be Active or Closed.

· Award Status: Award status can be set to Active, Closed, or Expired.

Set up Award with a Project with Burden Rate

Create an Additional Project

1. Select the OKTA Single-Sign-On button and then complete the sign-in steps.

A screenshot of a login page

Description automatically generated

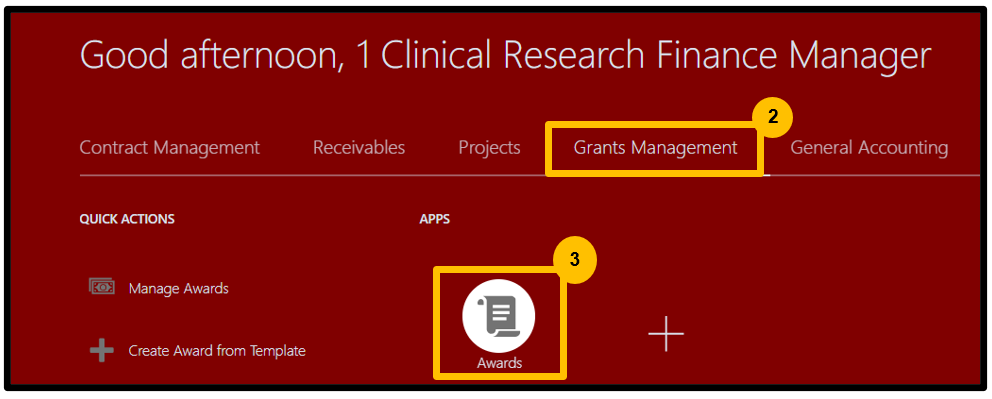

2. Select Grants Management.

3. Select Manage Awards.

A screenshot of a red box

Description automatically generated

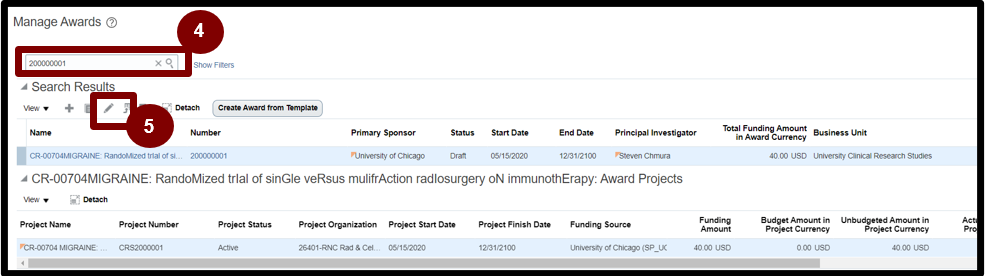

4. Search the Award.

5. Select the Pencil Icon.

A screenshot of a computer

Description automatically generated

6. Navigate to the (2) Train stop Projects.

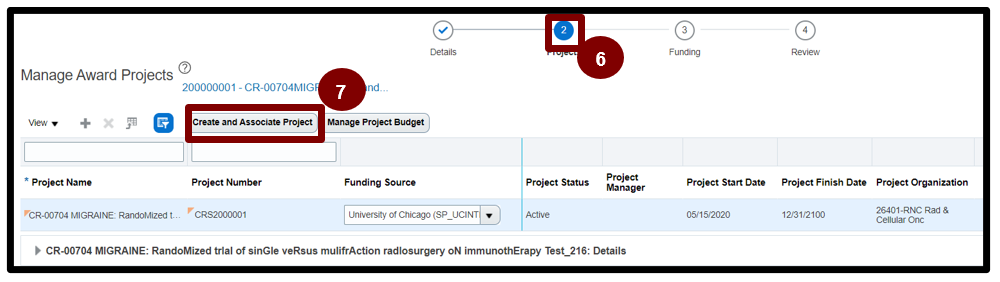

7. Select Create and Associate Project.

A screenshot of a computer

Description automatically generated

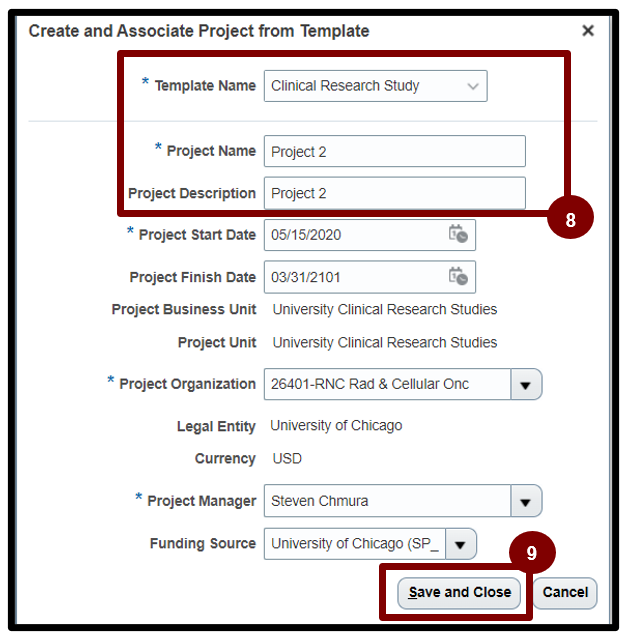

8. Enter Template Name: Clinical Research Study and Project Name 1 and 2.

9. Select Save and Close.

A screenshot of a project

Description automatically generated

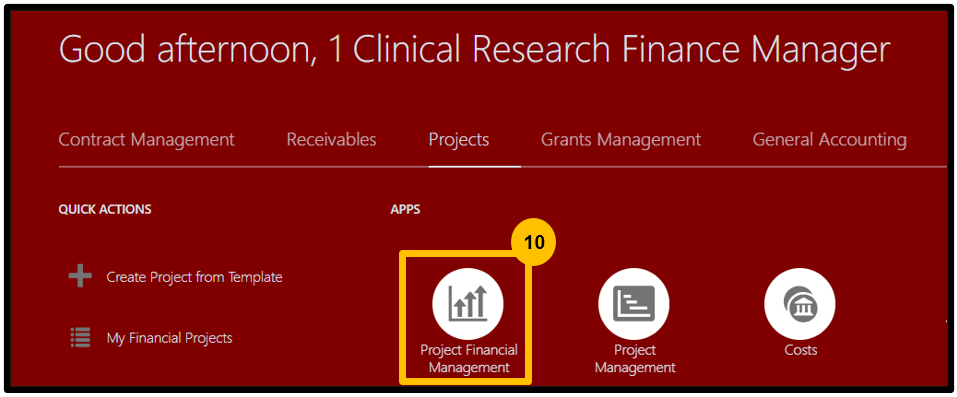

10. Navigate back Home then to Projects then Project Financial Management.

A screenshot of a red screen

Description automatically generated

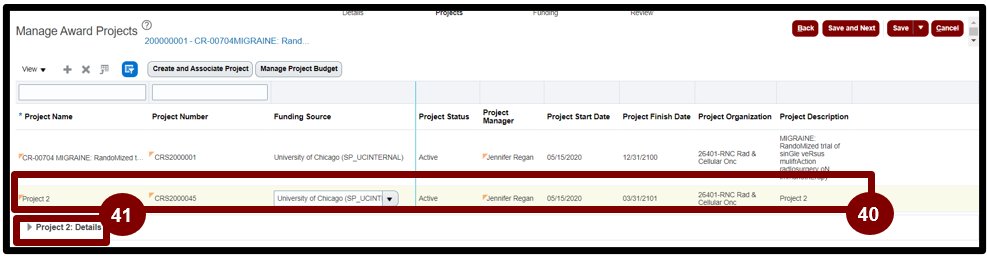

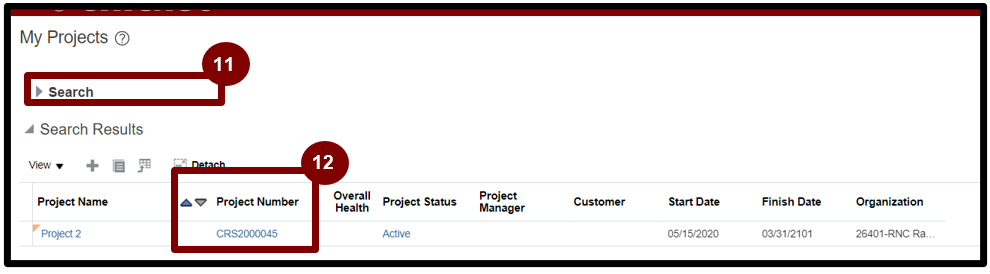

11. Search with Award Project.

12. Once populated, select the hyperlinked Project Number.

A screen shot of a computer

Description automatically generated

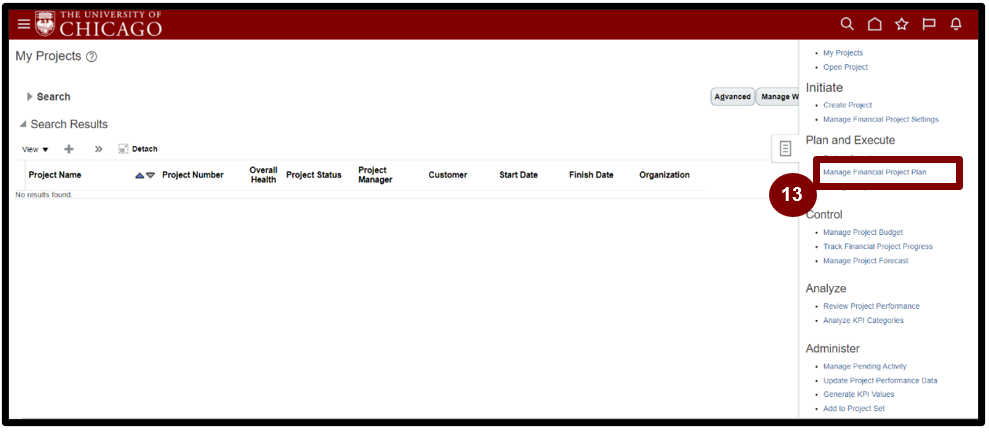

13. Navigate to the Task Panel then select Manage Financial Project Settings.

A screenshot of a computer

Description automatically generated

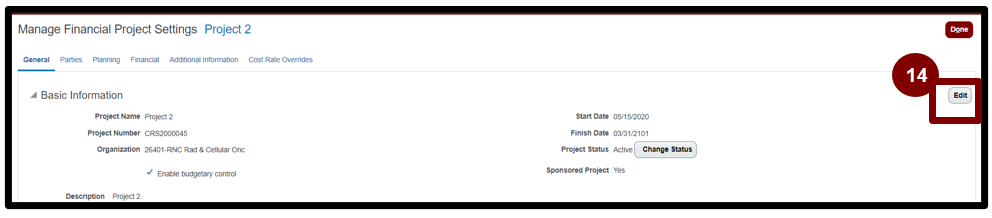

14. Select Edit.

A close-up of a card

Description automatically generated

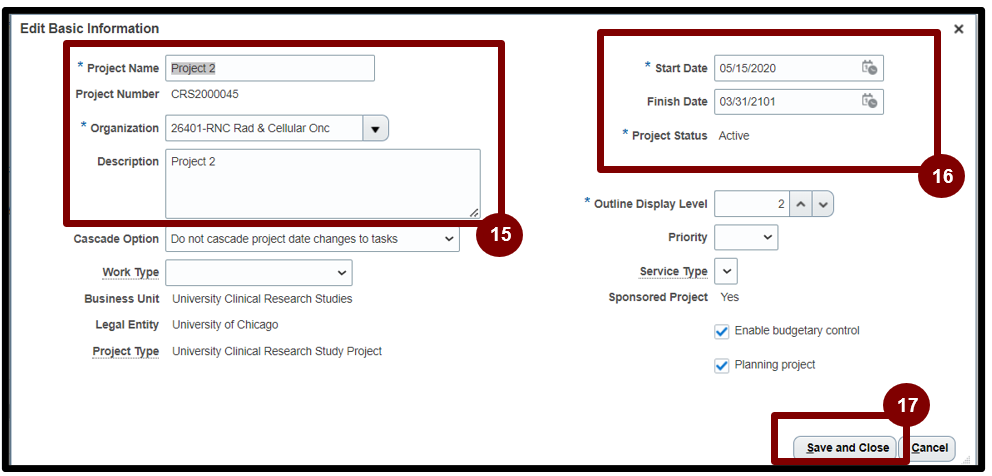

15. Update the Project Name and Description if required.

16. Review the Start Date and End Date and ensure Project Status is Active.

17. Select Save and Close.

A screenshot of a computer

Description automatically generated

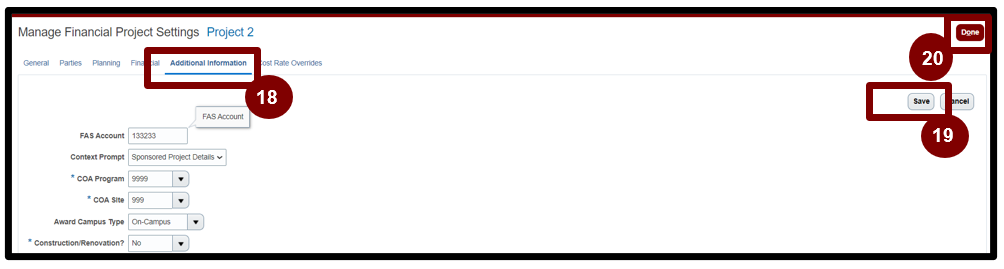

18. Select the Additional Information tab and validate the highlighted details.

19. Select Save.

20. Select Done.

A white rectangular frame with black border

Description automatically generated

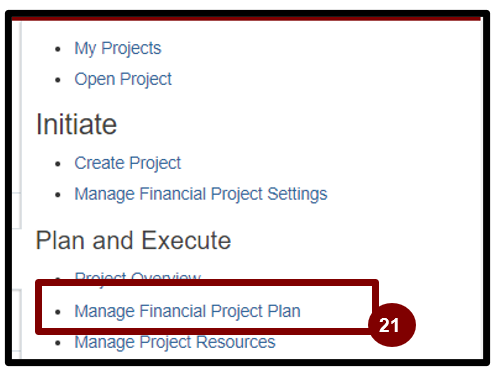

21. Navigate to the Task Panel and select Manage Financial Project Plan.

A screenshot of a project

Description automatically generated

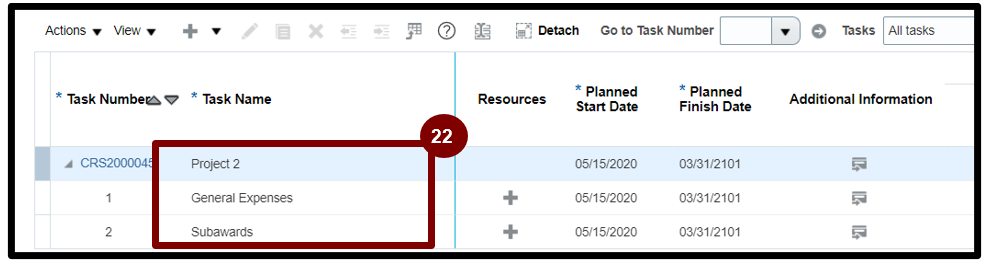

22. Review the tasks.

a. Note: Every Plan must have 2 tasks (General Expenses and Subawards).

A screenshot of a computer

Description automatically generated

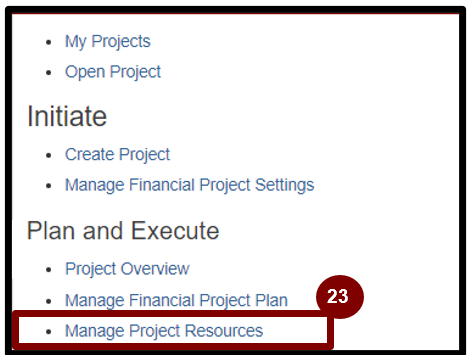

23. Navigate to the Task Panel then select Manage Project Resources.

A screenshot of a project

Description automatically generated

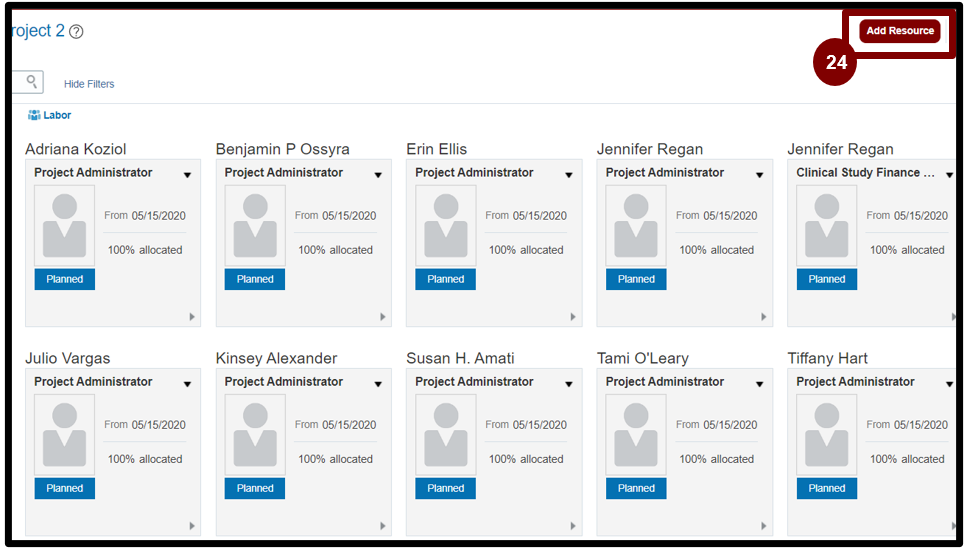

24. If the Project Manager has not been added, please select Add Resource and then proceed to add the Project Manager.

a. Note: It is essential to ensure that the Project Manager and the Clinical Study Finance Manager are the same. This step is essential for the Requisition and SubAward Requisition approval process.

A screenshot of a computer

Description automatically generated

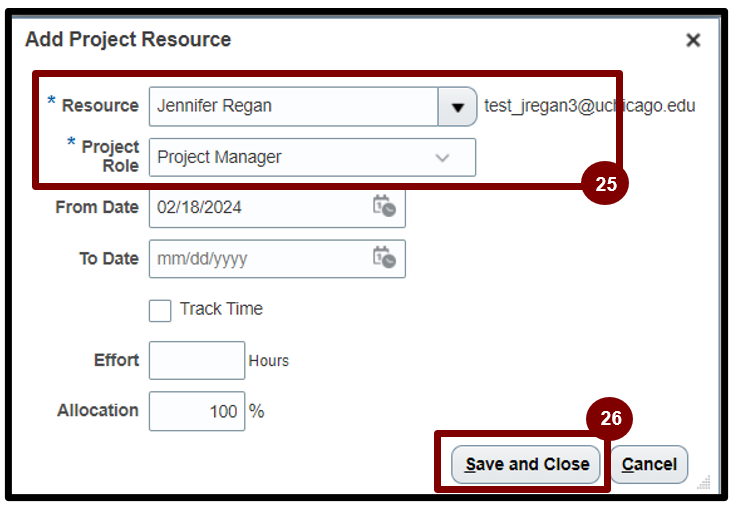

25. Enter Project Resource information as:

a. Resource: Name of Project Manager

b. Project Role: Project Manager

26. Select Save and Close.

A screenshot of a project manager

Description automatically generated

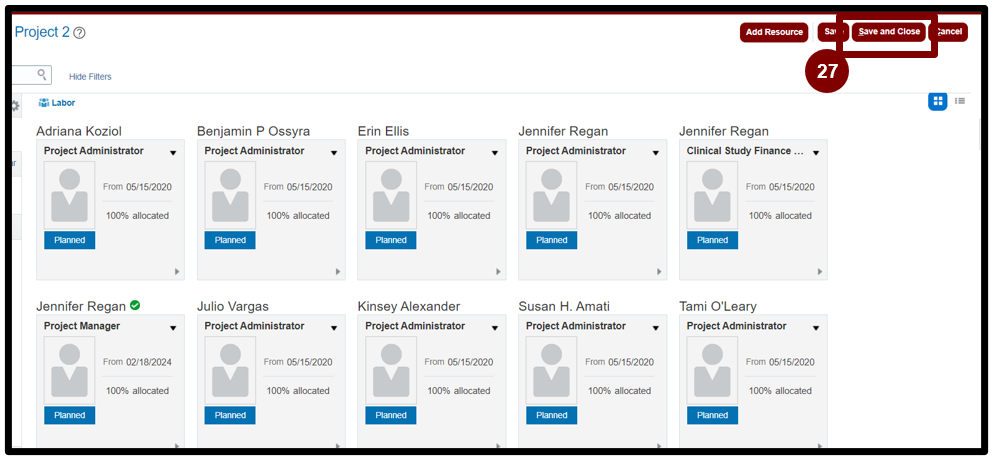

27. Select Save and Close on the Project Resources screen and then select Done.

A screenshot of a computer

Description automatically generated

28. Navigate Home then to Grants Management then Manage Awards.

A screenshot of a red box

Description automatically generated

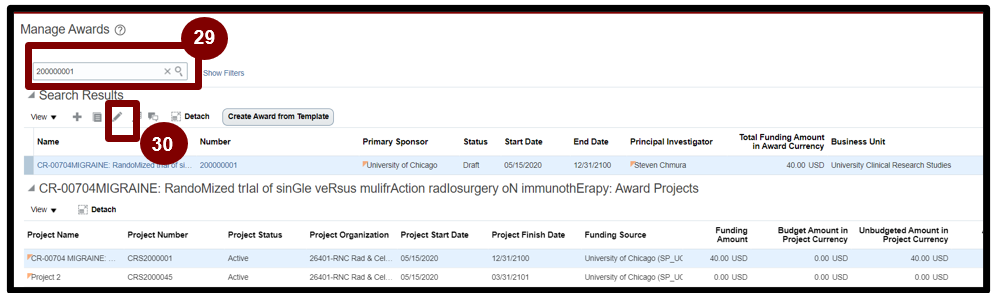

29. Search with the Award Number.

30. Select the pencil icon to edit the award when it populates.

A screenshot of a computer

Description automatically generated

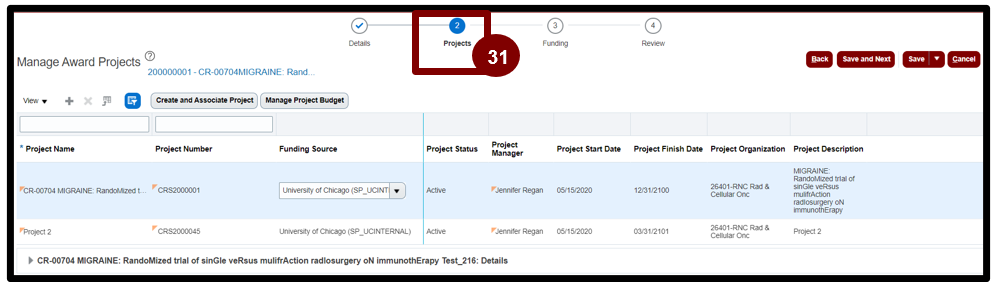

31. Navigate to the (2) Trainstop Projects and validate the highlighted columns:

a. Ensure Project Manager is populated and should not be Null.

b. Ensure Project Description is showing correct description.

A screenshot of a computer

Description automatically generated

Adding Burden Rate to First Project

32. Highlight the first Project Number.

A screenshot of a computer

Description automatically generated

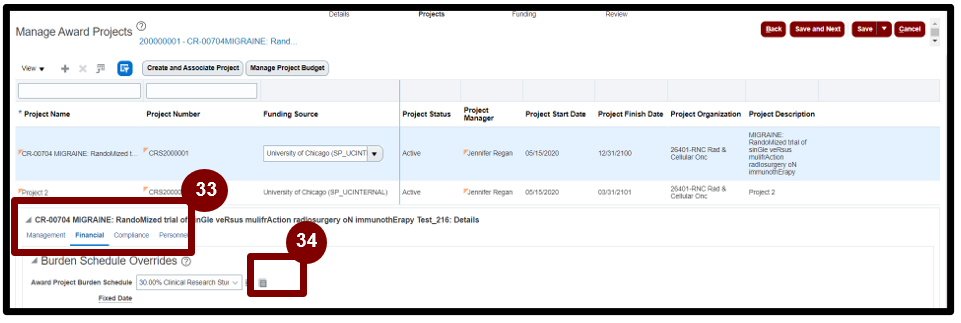

33. Expand Project Line to view the Financial tab.

34. Select Award Project Burden Schedule Build icon.

A close-up of a computer screen

Description automatically generated

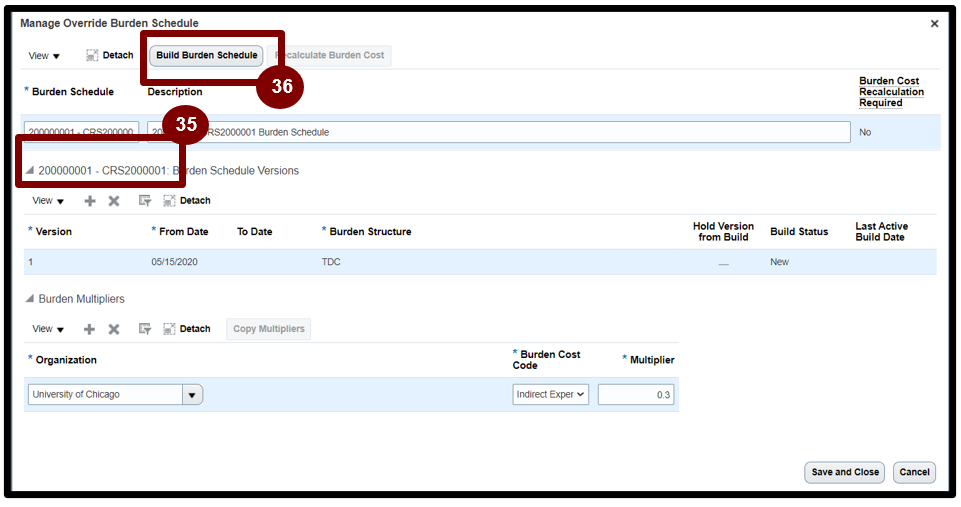

35. Expand Build Schedule Version View.

36. Select Build Burden Schedule.

A screenshot of a computer

Description automatically generated

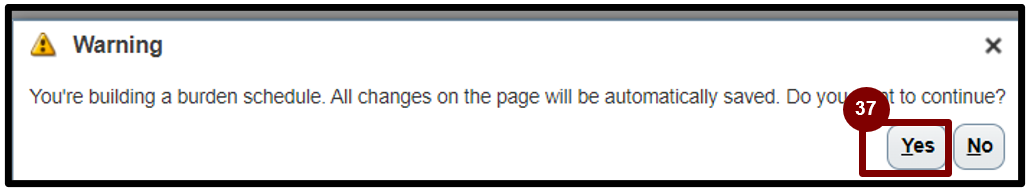

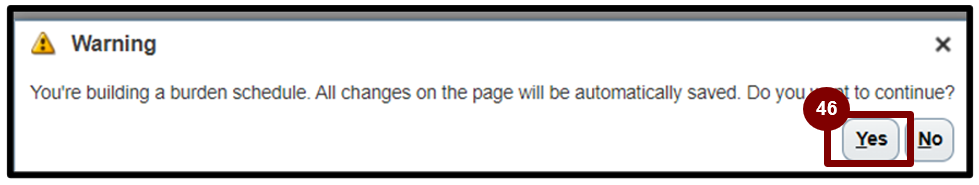

37. Select Yes then OK.

A black and white rectangular frame with black text

Description automatically generated

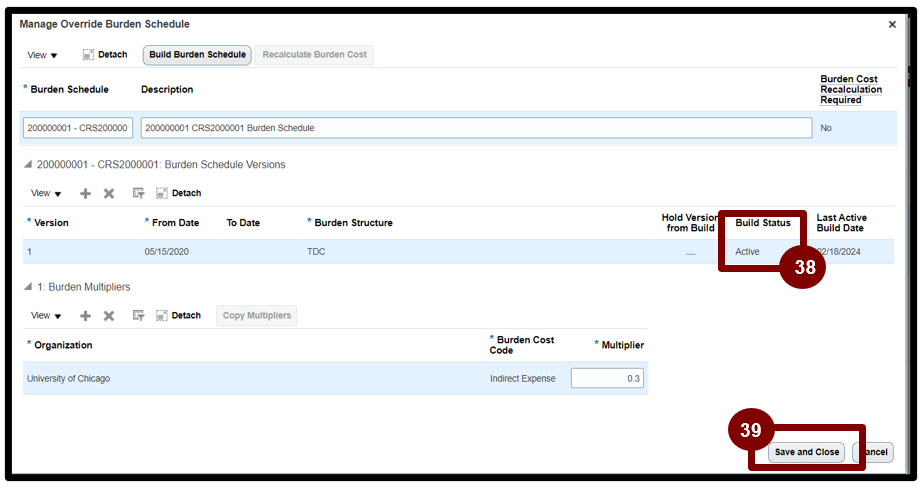

38. Ensure Build Status is showing Active.

39. Select save and Close.

A screenshot of a computer

Description automatically generated

Adding No Burden Rate to Second Project

40. Highlight the second Project Number.

41. Expand Project Line to view the Financial tab.

A screenshot of a computer

Description automatically generated

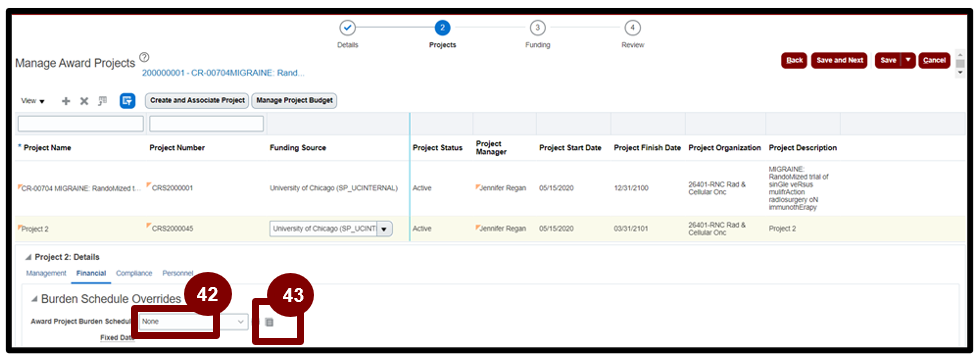

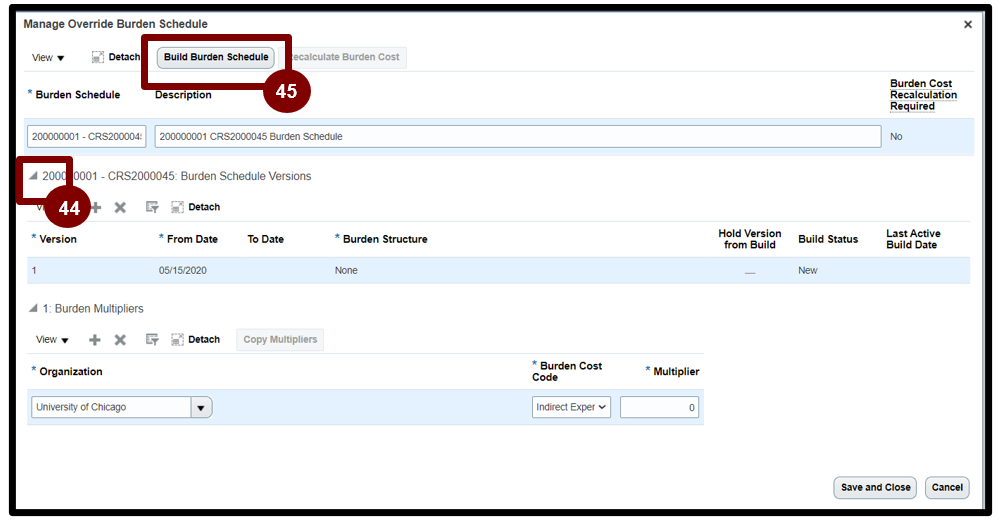

42. Select Award Project Burden Schedule: None.

43. Select Create Override Burden Schedule.

A screenshot of a computer

Description automatically generated

44. Expand Build Schedule Version View.

45. Select the Build Burden Schedule button.

A screenshot of a computer

Description automatically generated

46. Select Yes then OK.

A black and white rectangle with black text

Description automatically generated

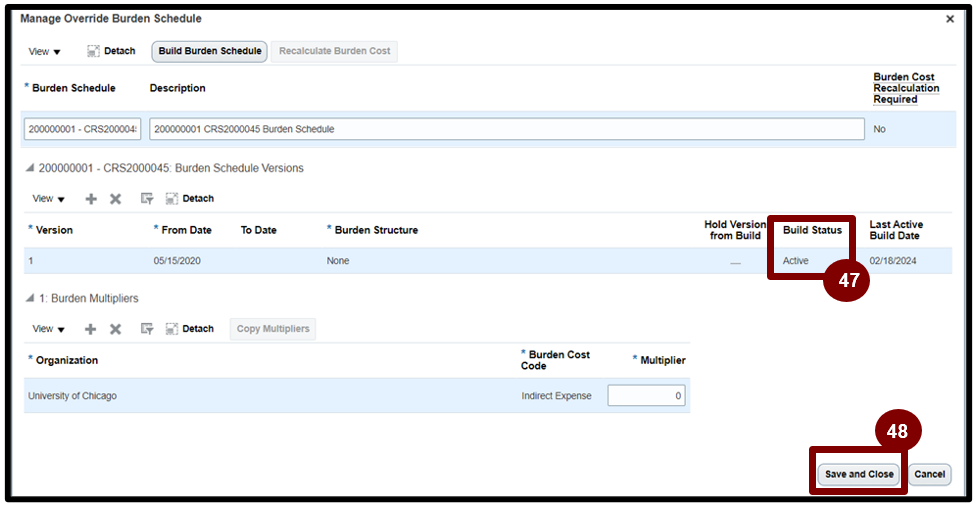

47. Ensure Build Status is showing Active.

48. Select Save and Close.

A screenshot of a computer

Description automatically generated

49. Navigate to the (3) Trainstop Funding.

50. Select Base-001.

A screenshot of a computer

Description automatically generated

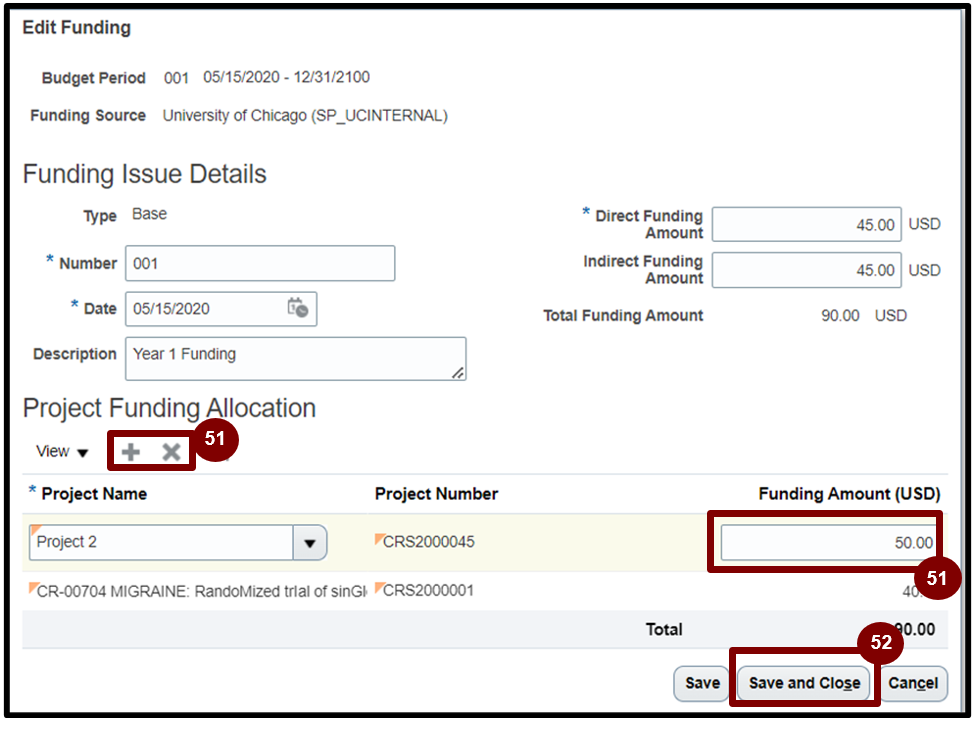

51. Select the Plus (+) Sign to add funding for the 2nd Project and populate the Funding Amount.

52. Select Save and Close.

A screenshot of a computer screen

Description automatically generated

53. Navigate to the (2) Trainstop Projects.

54. Select Manage Project Budget.

55. Select both Projects and Define the Budgets.

56. Once the budget is defined and baselined for both Projects select the Save and Next button.

A screenshot of a computer

Description automatically generated

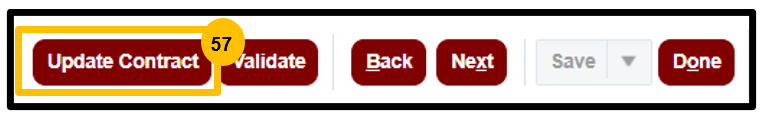

57. Select Update Contract.

A close-up of a red rectangle with white text

Description automatically generated

58. Select the Plus (+) Sign.

59. Add the 2nd Project Number.

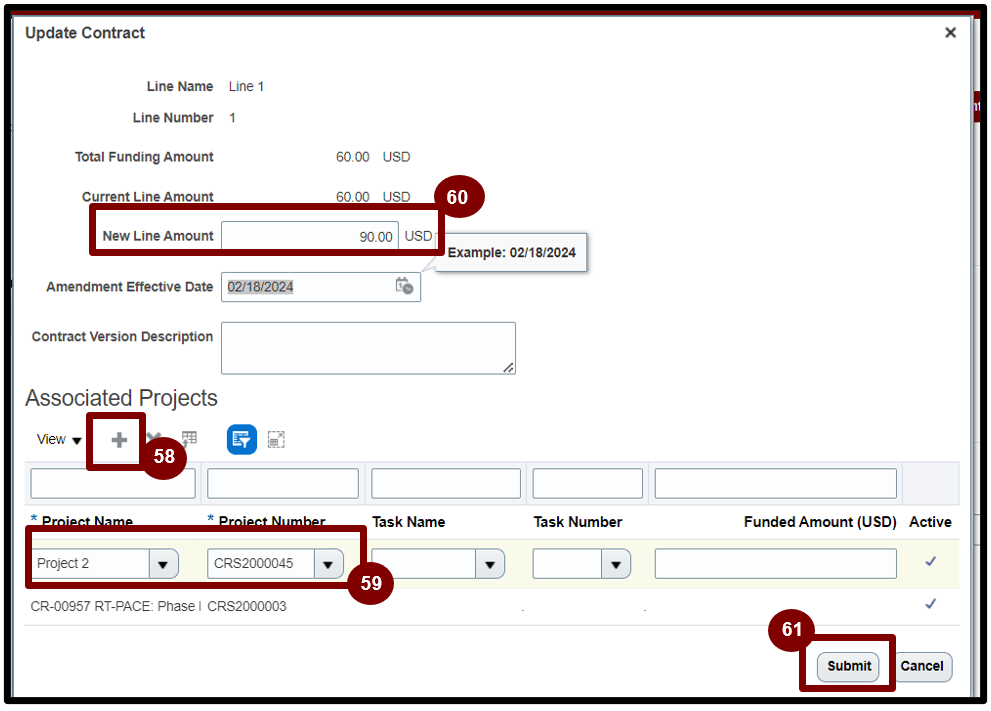

60. Update the New Line Amount to equal the Revised Funding Amount.

61. Select Submit.

A screenshot of a computer

Description automatically generated

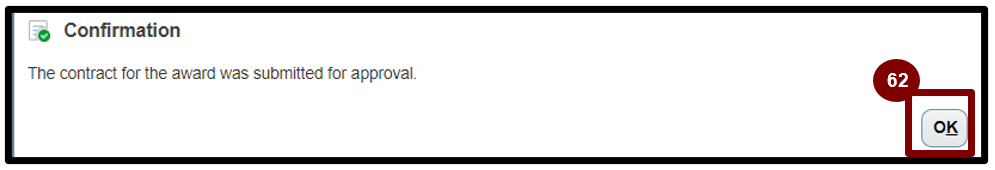

62. Select OK then Done.

A person writing on a whiteboard

Description automatically generated

63. Search the Award Number and ensure the status is changed to Active.

A screen shot of a computer

Description automatically generated

64. You have now completed the process of Setting up an Award with 2 Projects: 1 with and 1 without a Burden Rate.
